Road Resurfacing Projects

Share Road Resurfacing Projects on Facebook Share Road Resurfacing Projects on Twitter Share Road Resurfacing Projects on Linkedin Email Road Resurfacing Projects link

2026 Road Resurfacing Projects

The Town of Newmarket will be undertaking multiple road resurfacing projects in 2026. These projects will include grinding and resurfacing of the roadway, line painting, catch basin repairs, curb and sidewalk repairs and accessibility improvements.

Construction is anticipated to begin in the summer months, with traffic access to homes and businesses maintained throughout the duration of the work. Advance notice will be provided to residents regarding timelines and any potential disruptions to driveway access.

Please see below for the project locations and refer to the Project Updates section on the right-hand side of this page for the latest information.

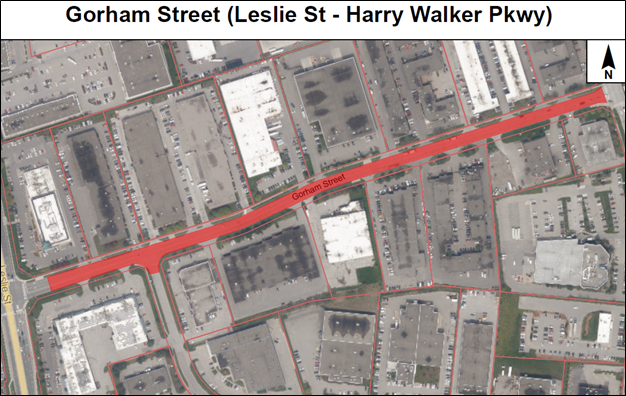

Gorham Street

Work on Gorham Street is anticipated to begin in 2026. Please check back for updates.

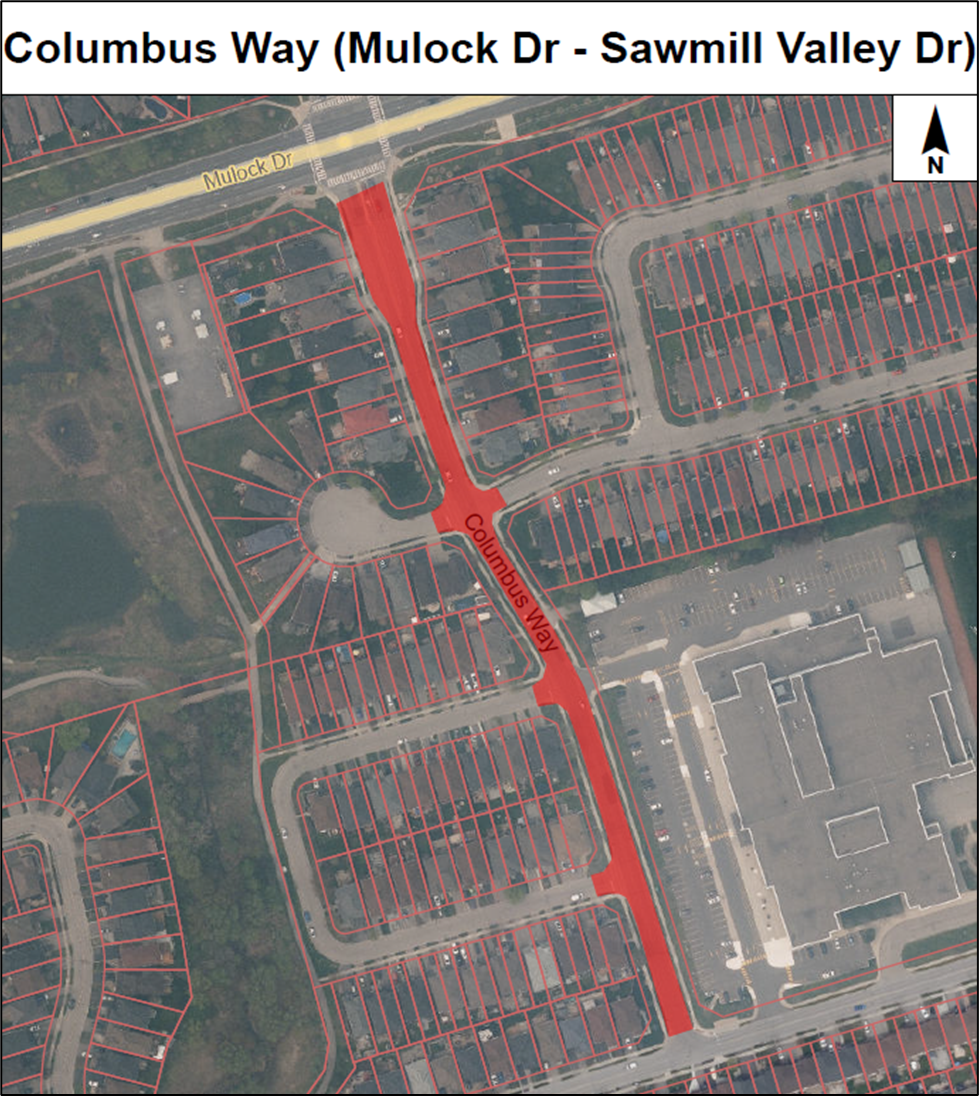

Columbus Way - May 2026

Work on Columbus Way is anticipated to begin in 2026. Please check back for updates.

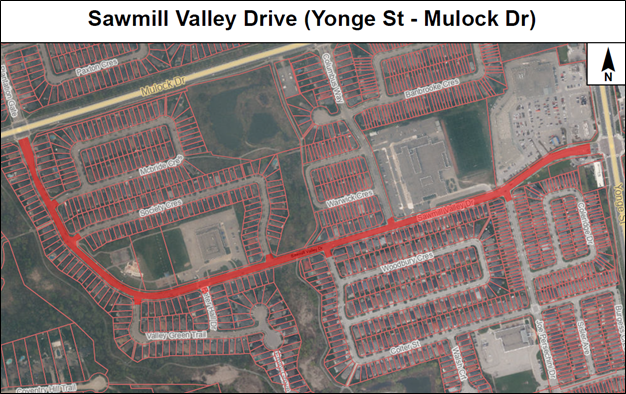

Sawmill Valley Drive - May 2026

Work on Sawmill Valley Drive is anticipated to begin in 2026. Please check back for updates.

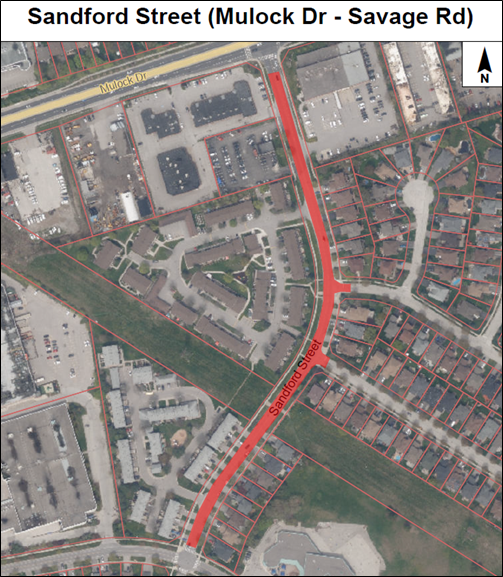

Sandford Street

Work on Sandford Street is anticipated to begin in 2026. Please check back for updates.

2026 Road Resurfacing Projects

The Town of Newmarket will be undertaking multiple road resurfacing projects in 2026. These projects will include grinding and resurfacing of the roadway, line painting, catch basin repairs, curb and sidewalk repairs and accessibility improvements.

Construction is anticipated to begin in the summer months, with traffic access to homes and businesses maintained throughout the duration of the work. Advance notice will be provided to residents regarding timelines and any potential disruptions to driveway access.

Please see below for the project locations and refer to the Project Updates section on the right-hand side of this page for the latest information.


Gorham Street

Work on Gorham Street is anticipated to begin in 2026. Please check back for updates.


Columbus Way - May 2026

Work on Columbus Way is anticipated to begin in 2026. Please check back for updates.


Sawmill Valley Drive - May 2026

Work on Sawmill Valley Drive is anticipated to begin in 2026. Please check back for updates.


Sandford Street

Work on Sandford Street is anticipated to begin in 2026. Please check back for updates.

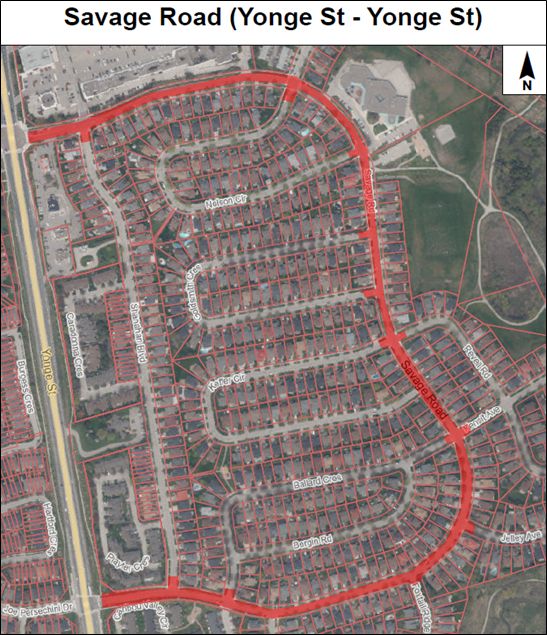

  • Project Update - Savage Road - Completed September 2025

    Share Project Update - Savage Road - Completed September 2025 on Facebook Share Project Update - Savage Road - Completed September 2025 on Twitter Share Project Update - Savage Road - Completed September 2025 on Linkedin Email Project Update - Savage Road - Completed September 2025 link
    CLOSED: This discussion has concluded.

    Project Update #6 - September 18th 2025

    Recent work completed:

    • All road work has been completed.

    • Restoration work for the interlock driveways are to take place starting this week.

    • Sod restoration will begin shortly after, likely early October

    What to expect over the next 2 weeks:

    • Various interlock driveways are to be restored

    • Sod will be placed in areas where sidewalk work occurred

    Project Update #5 - September 4th 2025

    Recent work completed:

    • Road resurfacing work has been completed

    • Majority of line painting has been completed

    What to expect over the next 2 weeks:

    • Various interlock driveways are to be restored

    • Continued line painting work for some crosswalks and urban shoulders

    • Sod will be placed in areas where sidewalk work occurred


    Project Update #4 - August 12th 2025

    Recent work completed:

    • All sidewalk work has been completed.

    • Boulevard areas where sidewalk have been replaced have been backfilled with topsoil in preparation of sod.

    • Curb removal and replacement work has begun

    What to expect over the next 2 weeks:

    • Continued removal and replacement of curb

    • Following curb work, asphalt grinding and driveway paving will commence


    Project Update #3 - July 29th 2025

    Recent work completed:

    • Majority of sidewalk work has been completed along the south side of Savage Road.

    • Boulevard areas where sidewalk have been replaced have been backfilled with topsoil in preparation of sod.

    What to expect over the next 2 weeks:

    • Continued removal and replacement of sidewalks along the north side.

    • Start of curb removals at residential and commercial driveways, following the sidewalk work.


    Project Update #2 - July 18th 2025

    Construction on Savage Road is underway. Recent work completed:

    • Saw cutting of existing curbs and sidewalks to prepare for removal and replacement.

    • Sidewalk removals have begun along the south side of Savage Road.

    • Curb removals and replacements are underway, starting mainly at intersections to maintain accessibility.

    What to expect over the next 2 weeks:

    • Continued removal and replacement of sidewalks.

    • Construction equipment and crews will remain active in the area; please use caution and follow posted signage.

    • Temporary pedestrian detours may be in place while work is ongoing.


    Project Update #1 - July 11th 2025

    Construction on Savage Road is scheduled to begin in July 2025. Over the next few weeks, residents will notice the placement of construction barrels and traffic control signage along the roadway.

    What to expect in the coming weeks:

    • Saw cutting of curbs and sidewalks will begin shortly after initial setup in preparation for removal.

    • Pedestrian access will be maintained on at least one side of the road at all times.

    • Short term disruptions to driveway access may occur during curb and sidewalk work. Notice will be provided to residents in advance.

    • Emergency access will be maintained at all times.

    Project Update #6 - September 18th 2025

    Recent work completed:

    • All road work has been completed.

    • Restoration work for the interlock driveways are to take place starting this week.

    • Sod restoration will begin shortly after, likely early October

    What to expect over the next 2 weeks:

    • Various interlock driveways are to be restored

    • Sod will be placed in areas where sidewalk work occurred

    Project Update #5 - September 4th 2025

    Recent work completed:

    • Road resurfacing work has been completed

    • Majority of line painting has been completed

    What to expect over the next 2 weeks:

    • Various interlock driveways are to be restored

    • Continued line painting work for some crosswalks and urban shoulders

    • Sod will be placed in areas where sidewalk work occurred


    Project Update #4 - August 12th 2025

    Recent work completed:

    • All sidewalk work has been completed.

    • Boulevard areas where sidewalk have been replaced have been backfilled with topsoil in preparation of sod.

    • Curb removal and replacement work has begun

    What to expect over the next 2 weeks:

    • Continued removal and replacement of curb

    • Following curb work, asphalt grinding and driveway paving will commence


    Project Update #3 - July 29th 2025

    Recent work completed:

    • Majority of sidewalk work has been completed along the south side of Savage Road.

    • Boulevard areas where sidewalk have been replaced have been backfilled with topsoil in preparation of sod.

    What to expect over the next 2 weeks:

    • Continued removal and replacement of sidewalks along the north side.

    • Start of curb removals at residential and commercial driveways, following the sidewalk work.


    Project Update #2 - July 18th 2025

    Construction on Savage Road is underway. Recent work completed:

    • Saw cutting of existing curbs and sidewalks to prepare for removal and replacement.

    • Sidewalk removals have begun along the south side of Savage Road.

    • Curb removals and replacements are underway, starting mainly at intersections to maintain accessibility.

    What to expect over the next 2 weeks:

    • Continued removal and replacement of sidewalks.

    • Construction equipment and crews will remain active in the area; please use caution and follow posted signage.

    • Temporary pedestrian detours may be in place while work is ongoing.


    Project Update #1 - July 11th 2025

    Construction on Savage Road is scheduled to begin in July 2025. Over the next few weeks, residents will notice the placement of construction barrels and traffic control signage along the roadway.

    What to expect in the coming weeks:

    • Saw cutting of curbs and sidewalks will begin shortly after initial setup in preparation for removal.

    • Pedestrian access will be maintained on at least one side of the road at all times.

    • Short term disruptions to driveway access may occur during curb and sidewalk work. Notice will be provided to residents in advance.

    • Emergency access will be maintained at all times.

  • Project Update - Gorham Street

    Share Project Update - Gorham Street on Facebook Share Project Update - Gorham Street on Twitter Share Project Update - Gorham Street on Linkedin Email Project Update - Gorham Street link

    Work on Gorham is anticipated to begin August 2025.

    Work on Gorham is anticipated to begin August 2025.

  • Project Update: Clearmeadow Boulevard - Completed August 2025

    Share Project Update: Clearmeadow Boulevard - Completed August 2025 on Facebook Share Project Update: Clearmeadow Boulevard - Completed August 2025 on Twitter Share Project Update: Clearmeadow Boulevard - Completed August 2025 on Linkedin Email Project Update: Clearmeadow Boulevard - Completed August 2025 link
    CLOSED: This discussion has concluded.

    Project Update #11- Clearmeadow Boulevard (Week of August 11th 2025)

    • Road resurfacing has been completed
    • Majority of line painting completed, with some remaining crosswalks and stop bars to be painted


    Project Update #10- Clearmeadow Boulevard (Week of August 4th 2025)

    • Road resurfacing will take place August 5th and 6th
    • After resurfacing work, line painting will commence


    Project Update #9- Clearmeadow Boulevard (Week of July 28th 2025)

    • Road grinding has been completed
    • Manhole adjustments have been completed
    • Base Asphalt repairs are scheduled for this week
    • Road Resurfacing is anticipated to begin later this week (Week of July 28th) or early next week (Week of August 4th), weather permitting


    Project Update #8- Clearmeadow Boulevard (Week of July 21st 2025)

    • Road grinding has begun in preparation for resurfacing work
    • After grinding work, manhole adjustments will take place
    • Resurfacing is expected to take place in in the following week (week of July 28th), weather permitting


    Project Update #7- Clearmeadow Boulevard (Week of December 2nd)

    • Due to unfavorable temperatures for paving, road resurfacing is postponed until summer 2025.
    • Driveway and boulevard restorations ongoing. To be completed by Early December (likely late this week or early next week)
    • A review of the resorted areas will be done in Spring 2025, and any areas that are not completed to the Towns satisfaction will be replaced.


    Project Update #6- Clearmeadow Boulevard (Week of November 25th)

    • Curb removal and replacements are complete.
    • Driveway and Sod restorations ongoing. To be completed by Early December.
    • Due to unfavorable temperatures for paving, road resurfacing is likely to be postponed until spring 2025. However, if an unseasonably warm day occurs in December, paving may proceed at that time. As it stands, the work is tentatively scheduled for spring 2025.


    Project Update #5- Clearmeadow Boulevard (Week of November 18th)

    • Curb removal and replacements are ongoing throughout Clearmeadow. Anticipated to be completed this week.
    • Driveway restorations and placement of topsoil and sod will commence in the next week or two.
    • Road paving is tentatively scheduled for the next 2 weeks- weather permitting. Should weather not allow for paving this year, then paving will be deferred to Spring 2025.


    Project Update #4 - Clearmeadow Boulevard (Week of November 11th)

    • Curb removal and replacements have begun throughout Clearmeadow.
    • Sidewalk removals and replacements are still underway along south side of Clearmeadow. The majority of the north side sidewalk work has been completed.
    • After completion of curb and sidewalk work, road grinding and manhole adjustments will begin- anticipated to start in 1-2 weeks, weather permitting.


    Project Update #3 - Clearmeadow Boulevard (Week of November 4th)

    • Crews have began sidewalk removal and replacements along the north side of Clearmeadow. Once complete, they will move to the south side of Clearmeadow and begin sidewalk removal and replacements on the south side.
    • After sidewalk removal and replacements are completed on the north and south sides of Clearmeadow, curb removals will begin.


    Project Update #2 - Clearmeadow Boulevard (Week of October 28th)

    • Crews will begin work on Clearmeadow this week, below is a summary of the upcoming work:
    • Curb Replacement: Concrete crews will be mobilizing on-site this week to begin curb replacement work along Clearmeadow Boulevard. You may see crews saw-cutting and removing sections of curb throughout the area. This is expected to take approximately 2–3 weeks to complete.
    • Road Grinding and Manhole Adjustments: Once curb replacements are complete, the contractor will proceed with grinding the road surface and adjusting manholes to prepare for paving.
    • Sidewalk Replacements: Weather permitting, sidewalk replacements may also take place this year. If weather conditions do not allow, this work will be postponed until next year. We will keep you informed with additional updates on the timing for sidewalk replacements


    Project Update #1 - Clearmeadow Boulevard

    • Please be advised that the start of Clearmeadow Boulevard Resurfacing has been slightly delayed and the project is now expected to begin in late October. We appreciate your understanding and will provide further updates as needed.

    Project Update #11- Clearmeadow Boulevard (Week of August 11th 2025)

    • Road resurfacing has been completed
    • Majority of line painting completed, with some remaining crosswalks and stop bars to be painted


    Project Update #10- Clearmeadow Boulevard (Week of August 4th 2025)

    • Road resurfacing will take place August 5th and 6th
    • After resurfacing work, line painting will commence


    Project Update #9- Clearmeadow Boulevard (Week of July 28th 2025)

    • Road grinding has been completed
    • Manhole adjustments have been completed
    • Base Asphalt repairs are scheduled for this week
    • Road Resurfacing is anticipated to begin later this week (Week of July 28th) or early next week (Week of August 4th), weather permitting


    Project Update #8- Clearmeadow Boulevard (Week of July 21st 2025)

    • Road grinding has begun in preparation for resurfacing work
    • After grinding work, manhole adjustments will take place
    • Resurfacing is expected to take place in in the following week (week of July 28th), weather permitting


    Project Update #7- Clearmeadow Boulevard (Week of December 2nd)

    • Due to unfavorable temperatures for paving, road resurfacing is postponed until summer 2025.
    • Driveway and boulevard restorations ongoing. To be completed by Early December (likely late this week or early next week)
    • A review of the resorted areas will be done in Spring 2025, and any areas that are not completed to the Towns satisfaction will be replaced.


    Project Update #6- Clearmeadow Boulevard (Week of November 25th)

    • Curb removal and replacements are complete.
    • Driveway and Sod restorations ongoing. To be completed by Early December.
    • Due to unfavorable temperatures for paving, road resurfacing is likely to be postponed until spring 2025. However, if an unseasonably warm day occurs in December, paving may proceed at that time. As it stands, the work is tentatively scheduled for spring 2025.


    Project Update #5- Clearmeadow Boulevard (Week of November 18th)

    • Curb removal and replacements are ongoing throughout Clearmeadow. Anticipated to be completed this week.
    • Driveway restorations and placement of topsoil and sod will commence in the next week or two.
    • Road paving is tentatively scheduled for the next 2 weeks- weather permitting. Should weather not allow for paving this year, then paving will be deferred to Spring 2025.


    Project Update #4 - Clearmeadow Boulevard (Week of November 11th)

    • Curb removal and replacements have begun throughout Clearmeadow.
    • Sidewalk removals and replacements are still underway along south side of Clearmeadow. The majority of the north side sidewalk work has been completed.
    • After completion of curb and sidewalk work, road grinding and manhole adjustments will begin- anticipated to start in 1-2 weeks, weather permitting.


    Project Update #3 - Clearmeadow Boulevard (Week of November 4th)

    • Crews have began sidewalk removal and replacements along the north side of Clearmeadow. Once complete, they will move to the south side of Clearmeadow and begin sidewalk removal and replacements on the south side.
    • After sidewalk removal and replacements are completed on the north and south sides of Clearmeadow, curb removals will begin.


    Project Update #2 - Clearmeadow Boulevard (Week of October 28th)

    • Crews will begin work on Clearmeadow this week, below is a summary of the upcoming work:
    • Curb Replacement: Concrete crews will be mobilizing on-site this week to begin curb replacement work along Clearmeadow Boulevard. You may see crews saw-cutting and removing sections of curb throughout the area. This is expected to take approximately 2–3 weeks to complete.
    • Road Grinding and Manhole Adjustments: Once curb replacements are complete, the contractor will proceed with grinding the road surface and adjusting manholes to prepare for paving.
    • Sidewalk Replacements: Weather permitting, sidewalk replacements may also take place this year. If weather conditions do not allow, this work will be postponed until next year. We will keep you informed with additional updates on the timing for sidewalk replacements


    Project Update #1 - Clearmeadow Boulevard

    • Please be advised that the start of Clearmeadow Boulevard Resurfacing has been slightly delayed and the project is now expected to begin in late October. We appreciate your understanding and will provide further updates as needed.
  • Project Update - Bristol Road - Completed December 2025

    Share Project Update - Bristol Road - Completed December 2025 on Facebook Share Project Update - Bristol Road - Completed December 2025 on Twitter Share Project Update - Bristol Road - Completed December 2025 on Linkedin Email Project Update - Bristol Road - Completed December 2025 link
    CLOSED: This discussion has concluded.

    Project Update #7 - Bristol Road (Week of December 2nd)

    • Paving of Bristol Road, Jack Rettie Court and Ashworth Drive have been completed

    Work scheduled for the next two weeks:

    • Placement of temporary line painting. Permanent line painting will be completed in Spring of 2025
    • Minor restoration work where sidewalks were replaced


    Project Update #6 - Bristol Road (Week of November 18th)

    • Asphalt grinding has finished on Bristol Road
    • Manhole adjustments have been completed
    • Driveway restorations are underway

    Work scheduled for the next two weeks:

    • Repairing base course asphalt
    • Paving
    • Line painting of newly paved road


    Project Update #5 - Bristol Road (Week of November 11th)

    • Asphalt grinding has began on Bristol Road
    • Manhole adjustments are taking place so they will be flush with new asphalt

    Work scheduled for the next two weeks:

    • Continuing Manhole adjustments
    • Continuing Asphalt grinding
    • Paving
    • Line painting of newly paved road


    Project Update #4 - Bristol Road (Week of November 5th)

    • All sidewalk replacements have been completed along Bristol Road
    • All curb replacements have been completed
    • Ashworth Drive curb and sidewalk work is complete
    • Sod restorations are being completed
    • As advised to residents, a 500 meter section of Bristol between Chester Ave and Main Street will have resurfacing postponed until 2025

    Work scheduled for the next two weeks:

    • Manhole adjustments
    • Asphalt grinding and paving
    • Line painting of newly paved road


    Project Update #3 - Bristol Road (Week of October 21st)

    • All sidewalk replacements have been completed along Bristol Road
    • The majority of curb replacements have been completed
    • Ashworth Drive work is under way

    Work scheduled for the next two weeks:

    • Top soil being placed in disturbed areas
    • Asphalt grinding and paving


    Project Update #2- Bristol Road (Week of September 30th):

    • Sidewalks and curbs replacements have been completed along the south side of Bristol Road
    • Crews are working along north side of Bristol Road and will take approximately 1-2 more weeks to complete concrete work on north side of Bristol Road

    Work scheduled for the next two weeks:

    • Continuing curb and sidewalk replacements on the north side of Bristol Road
    • Catch basin adjustments
    • Backfilling areas with topsoil to be restored with sod


    Project Update #1 - Bristol Road (Week of September 9th):

    • Concrete crew is onsite at Bristol Road
    • Sidewalks and curbs are being removed and replaced along the south side of Bristol Road
    • Sidewalks have been poured at both Dr. J.M. Denison Secondary School entrances

    Work scheduled for the next two weeks:

    • Move concrete work from the south side of Bristol Road to the north side
    • Catch basin adjustments

    Project Update #7 - Bristol Road (Week of December 2nd)

    • Paving of Bristol Road, Jack Rettie Court and Ashworth Drive have been completed

    Work scheduled for the next two weeks:

    • Placement of temporary line painting. Permanent line painting will be completed in Spring of 2025
    • Minor restoration work where sidewalks were replaced


    Project Update #6 - Bristol Road (Week of November 18th)

    • Asphalt grinding has finished on Bristol Road
    • Manhole adjustments have been completed
    • Driveway restorations are underway

    Work scheduled for the next two weeks:

    • Repairing base course asphalt
    • Paving
    • Line painting of newly paved road


    Project Update #5 - Bristol Road (Week of November 11th)

    • Asphalt grinding has began on Bristol Road
    • Manhole adjustments are taking place so they will be flush with new asphalt

    Work scheduled for the next two weeks:

    • Continuing Manhole adjustments
    • Continuing Asphalt grinding
    • Paving
    • Line painting of newly paved road


    Project Update #4 - Bristol Road (Week of November 5th)

    • All sidewalk replacements have been completed along Bristol Road
    • All curb replacements have been completed
    • Ashworth Drive curb and sidewalk work is complete
    • Sod restorations are being completed
    • As advised to residents, a 500 meter section of Bristol between Chester Ave and Main Street will have resurfacing postponed until 2025

    Work scheduled for the next two weeks:

    • Manhole adjustments
    • Asphalt grinding and paving
    • Line painting of newly paved road


    Project Update #3 - Bristol Road (Week of October 21st)

    • All sidewalk replacements have been completed along Bristol Road
    • The majority of curb replacements have been completed
    • Ashworth Drive work is under way

    Work scheduled for the next two weeks:

    • Top soil being placed in disturbed areas
    • Asphalt grinding and paving


    Project Update #2- Bristol Road (Week of September 30th):

    • Sidewalks and curbs replacements have been completed along the south side of Bristol Road
    • Crews are working along north side of Bristol Road and will take approximately 1-2 more weeks to complete concrete work on north side of Bristol Road

    Work scheduled for the next two weeks:

    • Continuing curb and sidewalk replacements on the north side of Bristol Road
    • Catch basin adjustments
    • Backfilling areas with topsoil to be restored with sod


    Project Update #1 - Bristol Road (Week of September 9th):

    • Concrete crew is onsite at Bristol Road
    • Sidewalks and curbs are being removed and replaced along the south side of Bristol Road
    • Sidewalks have been poured at both Dr. J.M. Denison Secondary School entrances

    Work scheduled for the next two weeks:

    • Move concrete work from the south side of Bristol Road to the north side
    • Catch basin adjustments
Page last updated: 15 Apr 2026, 09:31 AM
